Jumping Creek Road Upgrade
The Jumping Creek Road Upgrade is a major project to reconstruct the entire length of Jumping Creek Road, from Ringwood-Warrandyte Road in Warrandyte to Homestead Road in Wonga Park.
- Read our latest community flyer for the latest information on upcoming intersection works
- Works happening in 2025 and 2026
- About the Jumping Creek Road Upgrade
- Why is this upgrade needed?
Questions?
Contact us on 9840 9333 or at manningham@manningham.vic.gov.au.
The Jumping Creek Road Upgrade is a major project to reconstruct the entire length of Jumping Creek Road, from Ringwood-Warrandyte Road in Warrandyte to Homestead Road in Wonga Park.
- Read our latest community flyer for the latest information on upcoming intersection works
- Works happening in 2025 and 2026
- About the Jumping Creek Road Upgrade
- Why is this upgrade needed?
Questions?
Contact us on 9840 9333 or at manningham@manningham.vic.gov.au.
-
Upcoming intersection works on Jumping Creek Road
Share Upcoming intersection works on Jumping Creek Road on Facebook Share Upcoming intersection works on Jumping Creek Road on X (formerly Twitter) Share Upcoming intersection works on Jumping Creek Road on Linkedin Email Upcoming intersection works on Jumping Creek Road linkWe're fixing the road and kerb along Jumping Creek Road in stages.

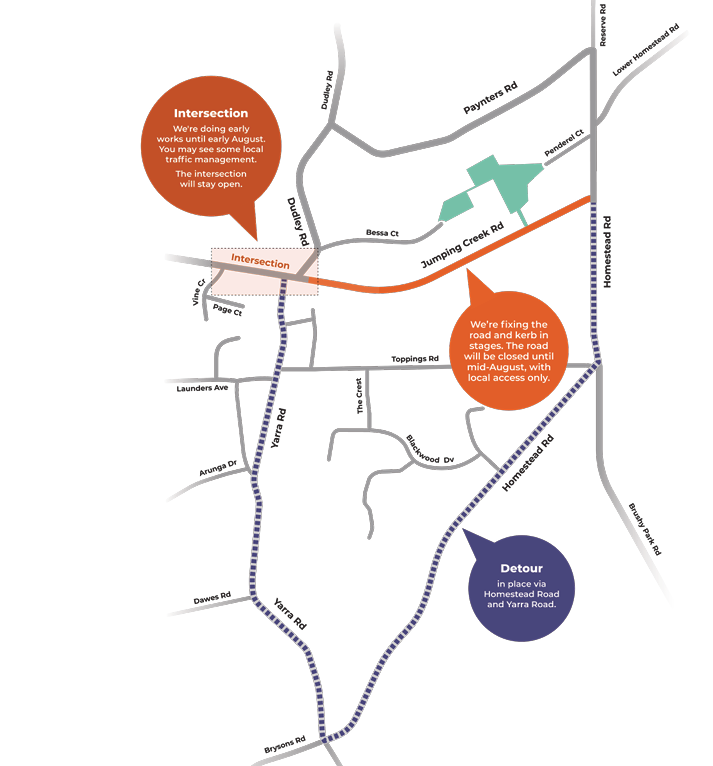

Early works are underway and expected to continue until mid-August 2026.
Find out more in our latest community flyer. Further updates will be shared as works progress.

We're fixing the road and kerb along Jumping Creek Road in stages.
Early works are underway and expected to continue until mid-August 2026.
Find out more in our latest community flyer. Further updates will be shared as works progress.

-
Safer travel and better access delivered on Jumping Creek Road
Share Safer travel and better access delivered on Jumping Creek Road on Facebook Share Safer travel and better access delivered on Jumping Creek Road on X (formerly Twitter) Share Safer travel and better access delivered on Jumping Creek Road on Linkedin Email Safer travel and better access delivered on Jumping Creek Road linkUpgraded footpaths, safer road conditions, and strong environmental protections are just some of the major improvements we have have delivered for the community as part of the Jumping Creek Road upgrade.
Manningham Mayor, Cr Jim Grivas, said the upgrade of the vital transport corridor would achieve safe, sustainable and functional infrastructure while protecting the surrounding environment.
“This project isn’t just about upgrading a road – it’s about protecting and enhancing the natural environment that surrounds Jumping Creek Road and makes the area so special,” Cr Grivas said.“From wildlife crossings to indigenous planting, we’re delivering improvements that support our community while protecting our local ecosystem for years to come.
“We’re also improving access for pedestrians and cyclists, with 4 kilometres of footpaths upgraded between the Warrandyte roundabout and Homestead Road.
“In addition, more than 800 drainage systems have been installed. These upgrades will significantly improve stormwater management and enhance safety for motorists and all road users,” Cr Grivas said.
Environmental protection measures are a key feature of the upgrade, which to date have seen:
- 6 wildlife crossings to support safe animal movement
- around 20 virtual fencing systems to help reduce wildlife-vehicle collisions
- 300 indigenous trees planted around the state park to enhance biodiversity and revegetation.
Construction continues across the remaining sections, with a focus on minimising disruption for residents while delivering long-term benefits for all road users.
Upgraded footpaths, safer road conditions, and strong environmental protections are just some of the major improvements we have have delivered for the community as part of the Jumping Creek Road upgrade.
Manningham Mayor, Cr Jim Grivas, said the upgrade of the vital transport corridor would achieve safe, sustainable and functional infrastructure while protecting the surrounding environment.
“This project isn’t just about upgrading a road – it’s about protecting and enhancing the natural environment that surrounds Jumping Creek Road and makes the area so special,” Cr Grivas said.“From wildlife crossings to indigenous planting, we’re delivering improvements that support our community while protecting our local ecosystem for years to come.
“We’re also improving access for pedestrians and cyclists, with 4 kilometres of footpaths upgraded between the Warrandyte roundabout and Homestead Road.
“In addition, more than 800 drainage systems have been installed. These upgrades will significantly improve stormwater management and enhance safety for motorists and all road users,” Cr Grivas said.
Environmental protection measures are a key feature of the upgrade, which to date have seen:
- 6 wildlife crossings to support safe animal movement
- around 20 virtual fencing systems to help reduce wildlife-vehicle collisions
- 300 indigenous trees planted around the state park to enhance biodiversity and revegetation.
Construction continues across the remaining sections, with a focus on minimising disruption for residents while delivering long-term benefits for all road users.
-
Works will resume in the coming weeks
Share Works will resume in the coming weeks on Facebook Share Works will resume in the coming weeks on X (formerly Twitter) Share Works will resume in the coming weeks on Linkedin Email Works will resume in the coming weeks linkWorks will resume in the coming weeks, with contractors starting reconstruction of the road pavement between 66 Jumping Creek Road and Homestead Road. We will maintain property access during the works, however we encourage you to allow extra travel time with more significant disruptions expected. Early works will also begin after Easter at the Yarra Road and Dudley Road intersection, where crews will relocate power and other underground services
For further information, read our latest community flyer.
Works will resume in the coming weeks, with contractors starting reconstruction of the road pavement between 66 Jumping Creek Road and Homestead Road. We will maintain property access during the works, however we encourage you to allow extra travel time with more significant disruptions expected. Early works will also begin after Easter at the Yarra Road and Dudley Road intersection, where crews will relocate power and other underground services
For further information, read our latest community flyer.
-
Weather safety and emergency access during construction
Share Weather safety and emergency access during construction on Facebook Share Weather safety and emergency access during construction on X (formerly Twitter) Share Weather safety and emergency access during construction on Linkedin Email Weather safety and emergency access during construction linkWorks have resumed following a pause over the festive season. Jumping Creek Road remains closed to through traffic with traffic control measures onsite.
Weather safety and emergency access during construction
The Jumping Creek Road Upgrade will address safety concerns for all road users. As well as improving road safety, the project will provide increased vegetation, a recreational trail for walkers and cyclists, wildlife protection measures, improved road usability and an upgrade to the township intersection and streetscape.
Jumping Creek Road is accessible to emergency services at all stages during construction, with the following safety protocols in place:
- Contractors stop workContinue reading
Works have resumed following a pause over the festive season. Jumping Creek Road remains closed to through traffic with traffic control measures onsite.
Weather safety and emergency access during construction
The Jumping Creek Road Upgrade will address safety concerns for all road users. As well as improving road safety, the project will provide increased vegetation, a recreational trail for walkers and cyclists, wildlife protection measures, improved road usability and an upgrade to the township intersection and streetscape.
Jumping Creek Road is accessible to emergency services at all stages during construction, with the following safety protocols in place:
- Contractors stop work when temperatures reach 35°C.
- The road is made safe at the end of each work shift to accommodate emergency vehicle access and resident evacuation, if required.
- In an emergency, the road will be opened in line with recommendations from emergency services.
- We continue to liaise with emergency services to ensure they are aware of these works
For more information, read our February 2026 update.
-
Works have temporarily paused until 12 January 2026
Share Works have temporarily paused until 12 January 2026 on Facebook Share Works have temporarily paused until 12 January 2026 on X (formerly Twitter) Share Works have temporarily paused until 12 January 2026 on Linkedin Email Works have temporarily paused until 12 January 2026 linkDuring this time, Jumping Creek Road will remain closed to through traffic with a reduced traffic control presence onsite.

We’re aware of drivers using local streets to bypass construction, as well as speeding concerns in surrounding areas. Additional traffic management measures are being considered including:
- temporary speed cushions on side roads
- speed restrictions in and along detour routes
- temporary road closures
- additional traffic controllers.
We’re working with local authorities, including Warrandyte Police, to ensure they have a visible presence in the area. In addition, we are monitoring the traffic situation closely and will adjust our measures as needed to respond to community concerns and site conditions.
To find out more, read our December construction update.
During this time, Jumping Creek Road will remain closed to through traffic with a reduced traffic control presence onsite.

We’re aware of drivers using local streets to bypass construction, as well as speeding concerns in surrounding areas. Additional traffic management measures are being considered including:
- temporary speed cushions on side roads
- speed restrictions in and along detour routes
- temporary road closures
- additional traffic controllers.
We’re working with local authorities, including Warrandyte Police, to ensure they have a visible presence in the area. In addition, we are monitoring the traffic situation closely and will adjust our measures as needed to respond to community concerns and site conditions.
To find out more, read our December construction update.
-
Road reconstruction works are beginning on Jumping Creek Road
Share Road reconstruction works are beginning on Jumping Creek Road on Facebook Share Road reconstruction works are beginning on Jumping Creek Road on X (formerly Twitter) Share Road reconstruction works are beginning on Jumping Creek Road on Linkedin Email Road reconstruction works are beginning on Jumping Creek Road linkWorks take place from 5 November 2025 to end-2026 for road reconstruction on Homestead Road and Vine Crescent.
What to expect during construction:
Work hours Monday to Friday 7:00am to 5:30pm
Saturdays 7:00am to 1:00pm
You may notice some noise, dust and vibrations during these times.
Traffic impacts Temporary disruptions to local traffic along Jumping Creek Road.
The road will be closed to through traffic between the IGA and Homestead Road.
Buses are being routed through Toppings Road.
Pedestrian access Pedestrian access will be maintained.
Driveway impacts Residents will be able to access their properties based on traffic management advice.
Minor delays entering or exiting driveways.
Bin collection Please place your bins out as usual. If required, our contractor will assist in moving your bins.
Read our latest flyer for more updates.Jumping Creek Road closure from 5 November 2025 to end-2026

Works take place from 5 November 2025 to end-2026 for road reconstruction on Homestead Road and Vine Crescent.
What to expect during construction:
Work hours Monday to Friday 7:00am to 5:30pm
Saturdays 7:00am to 1:00pm
You may notice some noise, dust and vibrations during these times.
Traffic impacts Temporary disruptions to local traffic along Jumping Creek Road.
The road will be closed to through traffic between the IGA and Homestead Road.
Buses are being routed through Toppings Road.
Pedestrian access Pedestrian access will be maintained.
Driveway impacts Residents will be able to access their properties based on traffic management advice.
Minor delays entering or exiting driveways.
Bin collection Please place your bins out as usual. If required, our contractor will assist in moving your bins.
Read our latest flyer for more updates.Jumping Creek Road closure from 5 November 2025 to end-2026

-
Works have begun on the Dudley Road footpath
Share Works have begun on the Dudley Road footpath on Facebook Share Works have begun on the Dudley Road footpath on X (formerly Twitter) Share Works have begun on the Dudley Road footpath on Linkedin Email Works have begun on the Dudley Road footpath linkWorks have started on the Dudley Road footpath reconstruction and will continue until mid-October 2025.
Read our flyer for the latest update.
Construction phases and timingPHASE LOCATION IN BRIEF Phase 1
September to October 2025
Property 3 to 35 Dudley Road - Footpath construction.
- Underground drainage installation.
- Vehicle crossing reconstruction, where required.
Phase 2
October 2025 to October 2026
Property 66 Jumping Creek Road to Homestead Road - Underground drainage, kerb and channel installation.
- Road reconstruction and asphalting.
- Driveway upgrades, where required.
- Bus stop upgrades.
- Line-marking.
Phase 3
From early 2026
Timing to be confirmed.
Jumping Creek Road
Dudley Road intersectionContinue reading
Works have started on the Dudley Road footpath reconstruction and will continue until mid-October 2025.
Read our flyer for the latest update.
Construction phases and timingPHASE LOCATION IN BRIEF Phase 1
September to October 2025
Property 3 to 35 Dudley Road - Footpath construction.
- Underground drainage installation.
- Vehicle crossing reconstruction, where required.
Phase 2
October 2025 to October 2026
Property 66 Jumping Creek Road to Homestead Road - Underground drainage, kerb and channel installation.
- Road reconstruction and asphalting.
- Driveway upgrades, where required.
- Bus stop upgrades.
- Line-marking.
Phase 3
From early 2026
Timing to be confirmed.
Jumping Creek Road
Dudley Road intersection to Vine Crescent
- Traffic light installation.
- Road and footpath construction.
- Drainage installation.
- Bus stop upgrades.
- Other authority asset works.
Note: There are no traffic signal works at the Yarra Road intersection at this stage.
-
Reminder: Community information session on Monday 8 September
Share Reminder: Community information session on Monday 8 September on Facebook Share Reminder: Community information session on Monday 8 September on X (formerly Twitter) Share Reminder: Community information session on Monday 8 September on Linkedin Email Reminder: Community information session on Monday 8 September linkSince our community sessions in April, we’ve been working to find the best construction method and schedule that will minimise disruption for residents.
Because the chosen approach will affect how people living within the construction zone access their properties, we’ll be speaking directly with those residents over the coming months to help us decide the most suitable option. This will include property numbers 1 to 66 Jumping Creek Road.
In August, we’ll share an update on the selected construction method, including expected timing and impacts, so you’ll have all the information you need to navigate the upcoming works.
We’ll alsoContinue reading
Since our community sessions in April, we’ve been working to find the best construction method and schedule that will minimise disruption for residents.
Because the chosen approach will affect how people living within the construction zone access their properties, we’ll be speaking directly with those residents over the coming months to help us decide the most suitable option. This will include property numbers 1 to 66 Jumping Creek Road.
In August, we’ll share an update on the selected construction method, including expected timing and impacts, so you’ll have all the information you need to navigate the upcoming works.
We’ll also host a drop-in community session where you can view the final designs and ask any questions.
Drop-in session details
📅 Monday 8 September 2025
⏰ 4:00pm to 7:00pm
📍 Wonga Hall at 1-3 Launders Avenue, Wonga Park VIC 3115
Construction is anticipated to begin in September 2025, continuing through to late 2026.
-
Construction update: Jumping Creek Road bridge works - May 2025
Share Construction update: Jumping Creek Road bridge works - May 2025 on Facebook Share Construction update: Jumping Creek Road bridge works - May 2025 on X (formerly Twitter) Share Construction update: Jumping Creek Road bridge works - May 2025 on Linkedin Email Construction update: Jumping Creek Road bridge works - May 2025 linkUpcoming works at Jumping Creek Road Bridge
- Monday 19 May - footing excavation
- Tuesday 20 May - concrete placement
- 20 to 27 May - works paused while concrete sets
- Tuesday 27 May - barrier installation, potential painting
During this time, the speed limit around the bridge will be reduced to 40 km/hour.Upcoming works at Jumping Creek Road Bridge
- Monday 19 May - footing excavation
- Tuesday 20 May - concrete placement
- 20 to 27 May - works paused while concrete sets
- Tuesday 27 May - barrier installation, potential painting
During this time, the speed limit around the bridge will be reduced to 40 km/hour. -
Contractors have been appointed - works to commence in late April
Share Contractors have been appointed - works to commence in late April on Facebook Share Contractors have been appointed - works to commence in late April on X (formerly Twitter) Share Contractors have been appointed - works to commence in late April on Linkedin Email Contractors have been appointed - works to commence in late April linkThe Jumping Creek Road project has reached an exciting new milestone: contractors have been appointed and the works are planned to commence in late April.
What we heard at the recent community sessions
We thank everyone who came to our two community sessions in March 2025. Your questions and feedback have helped us understand how we can support the community through the upcoming works.
Some key themes highlighted at the sessions included:
- Concerns about traffic management: We’re working closely with our contractor to ensure we can minimise traffic impacts as much as possible.
- Concerns about speeding vehicles: We’re communicating withContinue reading
The Jumping Creek Road project has reached an exciting new milestone: contractors have been appointed and the works are planned to commence in late April.
What we heard at the recent community sessions
We thank everyone who came to our two community sessions in March 2025. Your questions and feedback have helped us understand how we can support the community through the upcoming works.
Some key themes highlighted at the sessions included:
- Concerns about traffic management: We’re working closely with our contractor to ensure we can minimise traffic impacts as much as possible.
- Concerns about speeding vehicles: We’re communicating with other relevant authorities about whether additional control measures can be implemented.
- Questions about works at Dudley Road and Jumping Creek Road intersection: we’re in the process of seeking Department of Transport and Planning approval to install a signalised intersection in this location. We will update you once we know more.
- Requests to ensure pedestrian movement and the school crossing at Jumping Creek Road, Dudley Road and Yarra Road remain available and safe during construction.
When will the works begin?The first stage of works will begin after Easter and includes the construction of the Yarra Road footpath, along with early site investigations on Jumping Creek Road and Dudley Road. We anticipate some temporary disruptions to the community during these works.
In preparation for the main construction works, we’re working closely with our contractors to finalise a construction methodology that minimises any impacts on residents.
What’s happening and where?
The project aims to improve safety and connectivity for residents and users of Jumping Creek Road.
Location Scope of works Jumping Creek Road
Between Vine Crescent and Homestead Road, including the township.
- Relocating essential services
- Road reconstruction
- Installing underground drainage, kerb and channel
- Bus stop upgrades
- Line-marking
- Constructing recreational path links
- Controlled vegetation removal
- Constructing retaining walls
- Installing safety barriers
Jumping Creek Road
Dudley Road intersection
- Traffic lights at Jumping Creek Road and Dudley Road intersection.
Dudley Road
Between property 3 and Wonga Park Primary School.
- Footpath construction.
Yarra Road
Between property 368 and the Homestead Road roundabout.
We’ve also started safety upgrades on nearby residential streets to help manage traffic during the works. This includes shallowing drains, adding signage and general road maintenance. Next steps
- After Easter, we will start site investigations for all three project sites, including Jumping Creek Road, Yarra Road and Dudley Road. These investigations will provide critical information to ensure the work progresses smoothly.
- On 28 April, we will commence the construction of the Yarra Road footpath.
- In June 2025, we will provide you with more information on the construction timings and impacts for the mains work on Jumping Creek Road and Dudley Road sites.
Come and see usOur project site office will be open at Wonga Park Hall on Wednesdays and Fridays, between 10.00am and 12.00pm, from June 2025. If you have any questions or concerns, please drop in and chat with us.
Follow Project
Project timeline
-
Stage one construction
Jumping Creek Road Upgrade has finished this stageRingwood-Warrandyte Road to Nelson Drive was upgraded from 2020 to 2022.
-
Concept design development for remaining stages
Jumping Creek Road Upgrade has finished this stage2022
-
Community consultation on concept design and staging
Jumping Creek Road Upgrade has finished this stage2022 to 2023
-
Community consultation on detailed design
Jumping Creek Road Upgrade has finished this stage2023
-
Construction of recreational trail and safety barriers
Jumping Creek Road Upgrade has finished this stage2023 to 2024
-
Early works and site investigations
Jumping Creek Road Upgrade has finished this stageApril to August 2025
- Yarra Road path construction
- Property dilapidation report investigations.
- Site investigations, including asset locating and depth proofing.
- Relocation of essential services.
- Controlled vegetation removal.
- Consultation with residents located within the construction zone.
-
Construction: Phase 1
Jumping Creek Road Upgrade has finished this stageSeptember to October 2025
Property 3 to 35 Dudley Road- Footpath construction
- Underground drainage installation
-
Construction: Phase 2
Jumping Creek Road Upgrade is currently at this stageNovember 2025 to October 2026
Property 66 Jumping Creek Road to Homestead Road
- Underground drainage, kerb and channel installation
- Road reconstruction and asphalting
- Driveway upgrades, where required
- Bus stop upgrades
- Line-marking
-
Construction: Phase 3
this is an upcoming stage for Jumping Creek Road UpgradeAugust to December 2026.
Dudley Road intersection to Vine Crescent
- Traffic light installation.
- Road and footpath construction.
- Drainage installation.
- Bus stop upgrades.
- Other authority asset works.
Document Library
-
2026
-
2025
-
Flyer - Community Update - December 2025 (635 KB) (pdf)
-
Flyer - Community Update - November 2025 (3.17 MB) (pdf)
-
Flyer - Community Update - October 2025 (3.17 MB) (pdf)
-
Flyer - Community Update - August 2025 (204 KB) (pdf)
-
Flyer - Resident Consultation Summary - August 2025 (160 KB) (pdf)
-
Flyer - Community Update - July 2025 (110 KB) (pdf)
-
Flyer - Community Update - April 2025 (371 KB) (pdf)
-
Flyer - Community Update - February 2025 (2.99 MB) (pdf)
-
-
2024
-
2023
-
Project Plans (14.3 MB) (pdf)
-
Township Design Options (1.38 MB) (pdf)
-
Jumping Creek Road Development Framework - July 2016 (2.76 MB) (pdf)
FAQs
- What works are happening in 2025 and 2026?
- Where is Jumping Creek Road?
- Why is the upgrade needed?
- What are the benefits of this road upgrade?
- What community consultation has been undertaken for this upgrade project?
- What is the Jumping Creek Road Community Reference Panel?
- What is the purpose of the Jumping Creek Road Development Framework?
- What upgrade works are proposed to be constructed and what improvements are expected?
- What urban design principles were used for this project?
- What will the works involve and will there be impacts while works take place?
- What about emergency service access?
- How will you minimise environmental impacts?
- How will you protect biodiversity including fauna and native vegetation?
- How will you protect water catchments/ hydrology?
- How will you protect and assess cultural and historical heritage assets?
